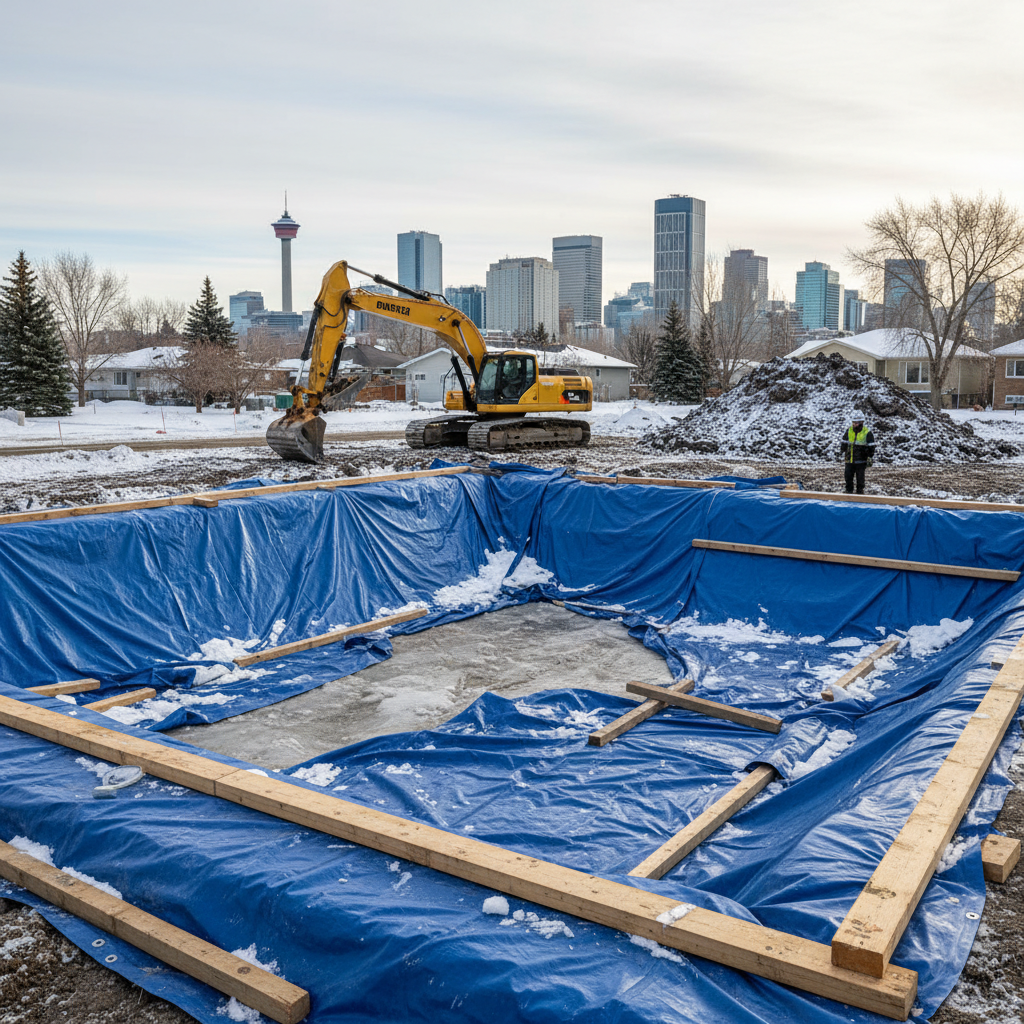

In Calgary, ground freezing during excavation is a leading cause of construction delays, structural risks, and costly corrections. With winter temperatures routinely dipping well below freezing from October through March-and often deeper-the freeze/thaw cycle poses unique hazards to excavation integrity, soil stability, and eventual finished structures. For homeowners, custom builders, and developers, familiarizing yourself with both the science and regulation behind excavation protection is essential for project success.
At the core of this challenge lie two critical provisions in the National Building Code (NBC): Section 9.12.1.3 and Section 4.2.5.7. These standards, which address the protection of excavation bottoms and sides from freezing and deterioration, are not mere technicalities-they’re key safeguards for your investment. Violating them risks not only your project’s safety and longevity but may also bring legal liability or fines. Navigating these requirements, while managing Calgary’s climate and the logistical realities of permitting, timelines, and costs requires careful, informed planning and often, the right professional partners.
Understanding the Hazards: Why Protecting Excavations from Freezing Matters
Excavation work exposes soil that, if left unprotected in Calgary’s winter, can freeze deeply-sometimes within hours. This problem isn’t limited to a superficial layer: frost can penetrate several feet, leading to heaving, expansion and contraction, and even lasting changes in soil properties. Frozen soil loses cohesiveness, becomes unstable, and can no longer safely support a foundation or slab. If construction proceeds on compromised ground, the risks include:
- Foundation settlement or movement later, resulting in cracks, shifting, or even structural failure.
- Frost heave pushing footings, piles, or slabs out of alignment, which can be difficult or impossible to correct after the fact.
- Delays and increased costs if frozen soil has to be remediated or replaced, or if thawing results in water issues, mud, or collapse of excavation sides.
- Worker safety hazards-slick, icy surfaces, unstable trenches, and falling debris.
- Regulatory non-compliance that can trigger failed inspections and mandated repairs, causing costly schedule setbacks.
In short, protecting an excavation from freezing is fundamental to a safe, code-compliant, and durable building-whether residential or commercial.
National Building Code: Key Provisions
The National Building Code (NBC) is the legal foundation for building safety in Alberta and Calgary. Two sections are particularly relevant to excavation and freezing risk:
Section 9.12.1.3 - Protection from Freezing
This section states: “The bottom of excavations shall be kept from freezing throughout the entire construction period.” (free.bcpublications.ca)
- Applies to all building excavations, especially footings, foundation trenches, and basements.
- Requires active protection against freezing for as long as the soil is exposed-the full period before concrete is poured or backfilling completed.
- No exceptions for single-family dwellings or small projects: all excavation bottoms must be protected.
Section 4.2.5.7 - Protection and Maintenance at Excavations
This structural section reinforces the above and adds:
“All sides of an excavation, supported and unsupported, shall be continuously maintained and protected from possible deterioration by construction activity or by the action of frost, rain, and wind.” (doczz.net)
- Covers not just the bottom, but all vertical and sloped sides of an excavation.
- Protection must be ongoing and must account for multiple meteorological threats, with frost (freezing temperatures) specifically mentioned.
- Applies to both supported (shored) and unsupported (open-cut) excavation sides.
These requirements are legal minimums-and enforcement in Calgary is active. Failing inspections for unprotected, frozen excavation can result in costly backtracking, stop-work orders, or a requirement to adjust soil, footings, or drainage at your expense.
The Calgary Climate: Seasonal Realities for Excavation Planning
Calgary’s unique combination of latitude, altitude (over 1,000 meters), and continental climate means ground frost can occur early and endure late. Data from Environment Canada shows:
- First Frost: As early as mid-September, but typically by late September ground frost is possible.
- Last Frost: Threat can persist until late May, though average safe date is mid-May.
- Deep Cold: Overnight lows below -20°C are common from December through February-enough to freeze exposed soil rapidly.
- Rapid Fluctuations: Chinooks can create wild temperature swings, but ground can remain frozen under an insulating snow pack even when air temperatures temporarily rise.
This creates a broad window where excavations are at risk-often from early fall to late spring.
Critical Timing: Scheduling Excavation and Foundation Work
Mitigating freezing risk starts with project planning. Whenever possible, excavation and foundation work should be scheduled during Calgary’s warmer months, ideally May to September. This “construction season” minimizes, but does not eliminate, the risk of frost. For many projects, however, scheduling and demand pressures mean work must proceed into the colder months. In such cases, additional planning for freezing protection becomes non-negotiable.
- For homeowners: Delays in finance, design, or permit approval may push excavation late into the year-budget for protection in your contingency plan.
- For builders and developers: Fast-tracked or multi-phase developments often require excavation over winter. Dedicated ground protection allowances are essential.
Practical Measures: How to Protect Excavations from Freezing
A range of strategies-sometimes used in combination-can keep Calgary excavations compliant during cold weather. Consider:
1. Scheduling Construction to Avoid Peak Frost Risk
Nothing is more effective, from both a financial and a risk-management perspective, than keeping earthmoving and foundation work within the window of low frost risk. Advise homeowners and clients to aim for foundation start dates after the last average frost date, typically in late May. If weather delays occur, reassess freezing risks daily as autumn approaches.
2. Insulation of Exposed Soil
When cold weather is unavoidable, insulation is the frontline defense. Typical products and methods include:
- Insulated Tarps or “Curing Blankets”: Heavy-duty, multi-layer tarps (poly face, with built-in foam or fiberglass) are placed directly over the excavation bottom and, if possible, up the sides. Application must be immediate after excavation, and blankets should overlap to prevent heat loss. Some models are reusable; others are disposable after heavy use.
- Expanded Polystyrene (EPS) or Rigid Foam Board: Used for larger, colder projects, these provide higher R-value (thermal resistance) but can be more expensive and harder to fit over uneven ground.
- Temporary Soil Coverings: In some cases, a combination of straw, plywood, and plastic sheeting is used, but effectiveness compared to commercial blankets is limited in severe cold.
- Heated Enclosures: For intricate sites (multi-family footings, commercial bases), building temporary, heated tents or enclosures around the excavation can provide both thermal and weather protection. This is a costly, but very reliable, option for high-value projects or extended open trenches.
Key Consideration: Monitored daily, insulation must stay in place whenever the temperature is below freezing, removed only for inspection, placing steel or pouring concrete, and replaced promptly if construction is delayed.
3. Ground Heating Systems
When insulation alone cannot maintain soil temperatures-such as multi-week delays or extreme cold-direct ground heating is required. Options include:
- Hydronic Ground Heaters: These units circulate heated glycol or water through a network of hoses or mats laid over or into the soil. They deliver even, consistent heat and are highly effective for large, deep, or critical excavations. Power requirements are substantial, and setup/operation is specialized.
- Electric Ground Heaters: Used for smaller areas, electrical resistance mats or cables can gently warm soil. They require careful power management and may not be suitable for very large jobs.
- Diesel or Propane-Powered Surface Heaters (Indirect Fired): Blow warm, dry air under insulating blankets, raising soil temperature. Portable and flexible, these systems are often paired with curing blankets on commercial sites.
Continuous monitoring is required for all ground-heating systems, especially during weekends and holidays. Fuel and electricity costs must be factored into your project budget.
4. Snow and Ice Management
Even if temperatures hover near freezing, snow cover insulates the ground but also traps moisture, which can freeze as temperatures fall. Before installing insulation or heating:
- Immediately remove any snow or ice after excavation or prior to pouring footings. Even a thin layer of ice between footing concrete and subgrade soil is unacceptable, as it prevents proper bonding.
- Keep excavation edges clear to prevent windblown snow from drifting in and re-freezing overnight.
Regular site maintenance-especially after snowfalls and during freeze/thaw cycles-prevents unplanned setbacks or safety incidents.
5. Dewatering and Drainage
Winter often brings rapid freeze/thaw cycles that can saturate exposed soils. Whenever water is present, the risk of ice formation and subsequent ground movement increases dramatically. Best practices include:
- Install temporary sump pumps in deeper excavations to remove meltwater swiftly.
- Grade bases and trenches to direct meltwater away from the foundation zone.
- Install sandbags or diversion ditches if heavy runoff is forecast.
Managing moisture is as critical as controlling temperature in minimizing soil disturbance and freezing hazards.
6. Shoring and Sidewall Protection
For deep or unstable digs, shoring isn’t just a safety requirement: it also limits the exposure of soil faces to cold wind and frost, preserving the structural competency of the excavation. Techniques include:
- Engineered Shoring Systems: Steel or timber frameworks that support trench walls and reduce risk of sloughing or collapse during freeze/thaw cycles.
- Temporary Enclosures: Insulated or heated panels fitted against open sidewalls can supplement shoring, reducing frost penetration further.
Consult with a geotechnical or structural engineer for challenging soils, sloped lots, or multi-storey foundations.
7. Temperature Monitoring and Recordkeeping
Best practice is to log soil temperatures during cold weather work, demonstrating diligence and due care for inspectors or insurers. Digital soil thermometers (probes) inserted at various depths provide an ongoing record-essential if future problems arise.
- Take and record readings daily, ideally both morning and evening, throughout excavation and foundation work.
- Include temperature logs in project documentation alongside permit approvals and inspection notes.
Permit Requirements in Calgary: What You Need Before Digging
Excavation and construction in Calgary is highly regulated to protect both public infrastructure and private property. For any homeowner, builder, or developer, obtaining proper municipal permits before excavation begins is not just smart legal practice, it is mandatory. Two primary permits are involved:
1. Excavation Permit (Roads Right-of-Way)
If your project involves digging within or adjacent to the City of Calgary’s road right-of-way (sidewalks, alleys, boulevards, or road surfaces), an excavation permit is required. Key notes:
- Application process is online via the City’s Roads department.
- Allow up to two business days for processing (calgary.ca).
- Documentation required: Site plan, work scope, expected impacts to traffic or public use.
- Administration fees, works inspection fees, and additional charges (for pavement restoration or degradation) may apply.
- Work must be scheduled within the approved permit window and re-inspected upon completion.
2. Building Permit (New Construction/Renovation)
For any new house construction or substantial addition, a building permit is required before site preparation begins. This ensures both design compliance and that site work will meet NBC and local safety requirements. Notes:
- Building permit application: Submit detailed plans, site grading/drainage strategies, and structural/architectural drawings (calgary.ca).
- Review may take approximately 21 days for a new single family dwelling.
- All permits must be in hand before commencing municipal inspections or pouring any footings.
Both permit types require the owner and/or contractor to demonstrate adherence to the National Building Code’s freezing protection standards. Documentation or inspection by City staff may be required, particularly if freezing conditions are present during excavation.
Costs and Fees: Budgeting for Freezing Protection
Construction in Calgary’s climate includes hidden costs, especially where weather risk requires active measures. Homeowners and builders often underestimate these additional line items, resulting in budget overruns. Four main categories of cost must be evaluated:
1. Permit Fees
- Excavation permit fees: Variable-determined by the area disturbed, impact to public right-of-way, and specific road usage. Administration and inspection fees are typically in the hundreds of dollars, with additional charges for damage to paved surfaces. Use the City’s online calculator for estimates (calgary.ca).
- Building permit fees: Proportional to total project value (cost of construction). Fees for new home construction or major additions often range from $1,000 to $4,000, but can be higher for large or complex sites. Calculate based on square footage and construction type (calgary.ca).
2. Material and Protection Costs
- Insulation blankets: Rent or buy; daily rates from $2-$6 per blanket per day. Large projects may use dozens at once. Purchase price: $80-$200 per blanket depending on size and brand.
- Rigid foam board: $30-$50 per 4’x8’ sheet. Required quantities depend on area covered.
- Hydronic ground heaters: Rental rates may range from $300-$1,000/day for commercial units, with additional fuel costs. Electric heaters run lower but require power planning.
- Temporary heated enclosures: Custom builds, scaffolding, and tarping can total $2,000-$10,000 for large-scale sites.
- Snow removal and shoring costs: Routine snow/ice clearing and shoring equipment rental can add several thousand dollars to winter projects.
3. Labour and Management Expenses
- Extra labour hours are often needed to place, monitor, and remove insulation or operate heating systems, especially late at night or on weekends.
- Site supervisors may need to devote extra time to temperature monitoring, documentation, and coordinating weather responses.
4. Contingency for Weather Delays
- In Calgary, plan for at least one to two weeks of weather-related delay over the winter construction period. Crew stand-by, rented equipment extension, or overnight heating can exceed initial projections.
- Budgeting a 10-15% contingency in project cost is standard prudence for winter work.
For cost-conscious homeowners, seeking estimates from specialty ground protection and equipment providers in advance-preferably before finalizing financing or contractor bids-is essential for financial control.
Project Timelines: Permit Processing, Construction, and Freezing Strategy
Timelines for excavation work in Calgary are shaped not just by construction logistics, but by both permitting and the realities of the weather. Strategic planning and advance permit applications can mean the difference between a seamless build and a winter-long headache.
Permit Processing Time
- Excavation permit: Up to 2 business days. However, factor in additional time for resubmission if documentation or clarifications are required (site plans, utility locates, etc.).
- Building permit: Estimated 21 days for new houses in Calgary. Add extra time for major additions, unique lots, or incomplete initial submissions.
- Do not break ground until both permits are active and inspections scheduled.
Construction Timeline
- Excavation can often be completed in 1-2 days for a typical single-family home, but foundation placement (formwork, rebar, concrete, curing) may stretch the “open” period to 1-3 weeks before backfilling.
- If temperatures drop below freezing during this window, all protective measures must be actively maintained. If frost enters after excavation, re-inspection and remediation (possibly over-excavation and new backfill) may be required, delaying the project further.
- For multi-unit or deep foundation projects, open excavation periods can be longer-sometimes several months. Contingency planning for extended freezing protection is critical.
Scheduling Inspections
- Inspections are required prior to footing or foundation pour. Be prepared to demonstrate compliance with NBC 9.12.1.3 and 4.2.5.7, especially if inspectors suspect soil has frozen since digging began.
- If weather turns suddenly, communicate with the City inspector to coordinate timely inspection and maintain compliance.
Managing Delays
- Unscheduled weather events (blizzards, sudden thaws followed by deep freezes) can force work stoppage. Temporary re-insulation or re-heating may be necessary.
- Keep contact information for equipment rental, snow removal, and ground heating providers on hand for rapid response.
Soil, Structure, and Safety: Technical Considerations Beyond Compliance
While meeting minimum code requirements is essential, best practice in Calgary involves anticipating “real-world” complications when dealing with freezing risk. Considerations include:
Soil Types and Frost Susceptibility
- Calgary soils vary from heavy clays (slow draining, high expansion potential), to sands and gravels (rapid draining, lower frost heave). Frost damage risk depends on your specific site’s soil profile-professional geotechnical assessment is recommended for infill, hillside, or custom builds.
- Clays soak up water and can expand dramatically when frozen (frost heave), while granular soil’s main hazard is settlement upon thawing.
Design Considerations
- Engineered solutions (deep piles, grade beams, enhanced insulation) may be specified by designers to mitigate poor soils or high frost risk sites.
- Discuss foundation system design options early if winter construction is expected.
Worker and Site Safety
- Frozen excavation floors and sloped sidewalls can become treacherous, increasing slip, trip, and fall risk. Implement mandatory PPE such as anti-slip boots and frequent sand or de-icing application on work paths.
- Shoring is not only a code requirement at certain depths but also critical to protect workers from soil collapse risk during freeze/thaw cycles, when ground can “slough” unexpectedly.
Long-Term Impact of Inadequate Freezing Protection
- Poorly managed winter excavations can result in permanent foundation movement, differential settlement, or ongoing water infiltration. These are costly to repair and can dramatically reduce property value.
- Insurance claims for frost-related foundation damage may be denied if poor construction practice is documented.
Compliance: Inspections, Documentation, and Avoiding Fines
Consistent, documented compliance with NBC and City of Calgary regulations offers threefold protection: it ensures physical safety, prevents failed inspections and costly corrections, and provides a valuable paper trail if disputes ever arise.
Meeting Code on Site
- Maintain insulation and/or heating systems in full working order until backfilling is complete and frost risk is eliminated.
- Have temperature logs, product documentation (for blankets or heaters), and photos or records of daily site conditions available for City inspectors.
- If an inspector finds evidence of frozen soil below footings or at the bottom of trenches, they may order corrective work (over-excavation and new engineered backfill), causing major delays and expenses.
Common Mistakes to Avoid
- Leaving exposed excavation bottoms overnight without insulation during unexpected cold snaps.
- Assuming shallow “surface frosting” is harmless-frost can penetrate rapidly, especially in compacted or moist soils.
- Overlooking permit conditions related to weather protection in city rights-of-way or high traffic areas (sidewalks, laneways).
Legal and Financial Penalties
- Fines and stop-work orders may be issued if proper freezing prevention is not in place, especially if excavation encroaches on public property.
- Failed inspections require resubmission and possible re-inspection fees, adding days or weeks to project timelines and labor budgets.
Case Examples: Impact of Freezing on Real Projects
Case 1: Unprotected Trench, Unexpected Cold Snap
A residential builder in Northwest Calgary scheduled a basement excavation in early October, expecting only minor frost risk. A three-day cold front dropped nighttime lows to -14°C. No blankets were installed. When excavation was inspected prior to footing pour, frost was found two inches below the base. The City required over-excavation and replacement with new engineered backfill-delaying the project by ten days and costing an additional $7,000 (labor, backfill, lost time, and equipment rental extension).
Case 2: Commercial Project with Hydronic Ground Heating
A multi-unit development downtown required foundation digging in January due to schedule overruns. The contractor deployed a full ground heating system (hydronic heater, blankets, temperature monitoring), maintaining soil temperature above 3°C for two weeks while forms were built. Despite a week of temperatures below -20°C, no freezing occurred, inspections passed, and the project proceeded on schedule-with added energy and rental costs, but no lost time or remedial work.
Case 3: Homeowner Self-Management Gone Wrong
A DIY builder underestimated the risk of frost in March, leaving a shallow trench open while securing materials. A three-day pause was enough for frost to penetrate, causing soil to expand and shift. When foundation walls were poured, unrecognized frost heave later resulted in a 3 cm tilt across the basement slab. The eventual warranty claim was denied, as temperature logs and freezing protection records were not maintained.
Planning Checklist: Ensuring Protection from Freezing in Excavations
- Step 1: Review project schedule and determine realistic risk window for frost/freezing based on historic Calgary temperature data.
- Step 2: Apply early for excavation and building permits to avoid late-season bottlenecks.
- Step 3: Engage qualifying contractors or ground protection providers. Confirm availability of insulating blankets, ground heaters, or shoring-especially during peak construction months.
- Step 4: Budget for all protective measures, including labor, rental, consumables, and a contingency for weather delays. Get written estimates from all suppliers.
- Step 5: Set up daily site inspection and temperature monitoring protocols. Inform the city inspector of protection plans and share logs if requested.
- Step 6: Respond dynamically to weather forecasts-install protection ahead of incoming cold waves, not after the fact.
- Step 7: Maintain all records, receipts, and logs as part of your project file for future reference or warranty validation.
The Role of Professional Help: When to Involve a Demolition & Excavation Company
While some small or shallow excavations can be managed by experienced DIYers, most foundation and structural projects in Calgary benefit from professional management, especially during the cold season. Qualified demolition and excavation contractors offer:
- Expertise: In-depth knowledge of NBC freezing protection standards and local permit requirements.
- Equipment: Access to a full suite of ground heaters, insulation, shoring, and snow removal machinery.
- Reliability: Proven systems for scheduling, documentation, and compliance with city inspections and test logs.
- Insurance: Backed by commercial liability and bonding, reducing risk to homeowners and developers.
- Cost Savings: Fewer delays and less corrective work, translating to overall lower risk and cost on winter projects.
For any large, deep, or schedule-sensitive build-especially when freezing risk is high-engage your demolition and excavation team early, and request their detailed plan for protective measures.
Conclusion: Building Right in Calgary’s Climate
Adhering to NBC Section 9.12.1.3 and 4.2.5.7 isn’t just a legal requirement-it’s essential to safely, efficiently, and cost-effectively building in Calgary. With cold temperatures impacting construction for nearly half the year, project success depends on careful planning, budgeting, and the selection of the right protective measures against excavation freezing. By obtaining permits early, working alongside experienced excavation professionals, and maintaining diligent site protocols, homeowners and builders can prevent costly structural issues and keep projects on track-no matter the season.
For expertise in cold-weather excavation protection, local code compliance, and timely project delivery in Calgary, partner with Kingsway Demolition & Excavation, your trusted site preparation specialists.
